Project Management

profilezhii_w

Please see the case  in attachment.


Here is the questions, Remaining responses for schedule compression should use the question-response format.

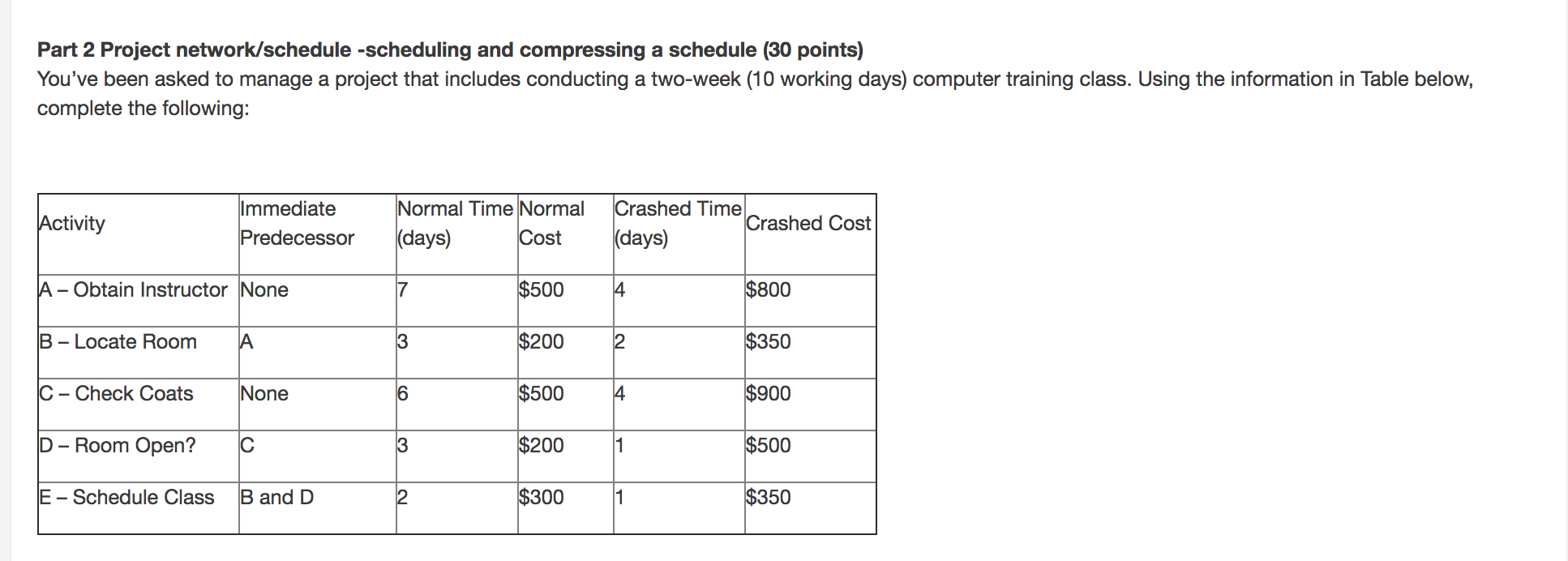

Schedule Compression:

  1. What is the crash cost per day for each activity?
  2. Which activities should be crashed to meet a project deadline of 10 days with a minimum cost? You may assume that you can partially crash an activity.
  3. What is the new cost after crashing the project?
  4. Fully crash the project to its minimum duration.  Prepare a table that shows (for each day the project length is reduced) the project duration, the activities that are crashed, the incremental crash cost, and the total crash cost.
